​​Operations Control Strategy​

​​The Digitale Schiene Deutschland is fundamentally redesigning the management of rail operations and setting the course for the future of digital control and safety technology (DLST: Digitale Leit- und Sicherungstechnik): With the so-called Operations Control Strategy, 94 operational centers and 52 technical systems centers are being set up throughout Germany in order to be able to operate in a more modern, decentralised and flexible manner in the future.​

Project duration

Start
2019
End
2034

Planned actions

Scope of equipment
  • 94 operational centers
  • 52 technical systems centers

Contact

DSD-Infrastructure projects

If you have any questions, connect with us via e-mail, please.

Disclaimer

The dates shown are legally non-binding forecasts based on the current status. The forecasts are in no way intended to establish any kind of legal claim whatsoever that completion will take place by the specified date and that use will be possible. For these reasons, the information should also not be used to make or prepare business decisions, for example, but not conclusively, with regard to the vehicle equipment or the compatibility between the vehicles and the infrastructure. If you have any questions, particularly regarding technical network access or obtaining binding information, please contact your customer advisor.



Most of the infrastructure projects are still in the planning phase, which means that the information provided on these pages reflects the current planning status and is updated regularly.

​​In order to achieve the goals of Digitale Schiene Deutschland (DSD), successfully shape the decarbonisation of transport and actively counter the constant changes in the rail transport environment, Deutsche Bahn is developing an innovative strategy for the future management of rail operations - the so-called Operations Control Strategy (BSS: Betriebssteuerungsstrategie).



​The BSS aims to enable efficient and reliable rail transport. The development of the future control centers takes into account running and operational aspects in the various regions. At the same time, continuous further development of the strategy ensures that tried-and-tested railway operating practices are maintained, necessary adjustments are made and new opportunities are utilised. For example, signallers will continue to work together in teams with operational or geographical areas of responsibility, the distribution of failure risk will be adapted across several locations and the new integrated control and operating system (iLBS: integriertes Leit- und Bediensystem) will be used as a standardised operating system for all DLST applications.



​The Operational Control Strategy includes the planning and construction of so-called operational centers (BSO: Bedienstandorte) and technical systems centers (TSO: Technikstandorte) - indispensable key elements for effective and modern operational control. Among other things, this involves determining the optimal locations throughout Germany, designing standard buildings and switching to new technologies and procedures.

​

​Operational centers (BSO: Bedienstandorte)



​The BSO create modern and attractive workplaces for signallers. The aim is to relocate control centers for planned interlocking projects or those already being implemented exclusively to BSO in the future. By equipping the BSO with iLBS, the BSS will meet the requirements of the future technologies of DSD. In addition to the conventional interlockings, the strategy also replaces Deutsche Bahn's seven operations centers.

Building view standard building BSO (Symbol image; Copyright: atelier4d Planung GmbH, DB InfraGO AG) Building view standard building BSO (Symbol image; Copyright: atelier4d Planung GmbH, DB InfraGO AG)
Building view standard building BSO (Symbol image; Copyright: atelier4d Planung GmbH, DB InfraGO AG)

​In order to maximise efficiency, a standard building is being developed for all BSO. This should guarantee a uniform standard throughout Germany, but at the same time be modularly adaptable to the different local requirements. A particular focus here is on flexible adaptation to the varying number of operator stations required.



​The first construction activities as part of the BSO are scheduled to begin in 2024. Approximately five years are scheduled for the planning and construction of a BSO. The majority of the BSO is to be realised by 2034.

​

​Technical systems centers (TSO: Technikstandorte)



​In contrast to the BSO, the TSO are set up in a standardised uniform size throughout Germany and are designed identically everywhere. TSO correspond to data centers with two server rooms in terms of their design, structure and operating model. These are used to control control units such as signals and point machines. The dimensioning of the rooms is based on the requirements of the manufacturer with the largest space requirement.



​One of the two computer rooms acts as a technical redundancy for the other room, meaning that safety-relevant components are duplicated. In the further course of the rollout of DLST, the aim is to combine the TSO into pairs, with one computer room then being available as so-called geo redundancy for the other TSO and vice versa.

Possible facade variant of a TSO for operations control (Symbol image; Copyright: atelier4d Planung GmbH, DB InfraGO AG) Possible facade variant of a TSO for operations control (Symbol image; Copyright: atelier4d Planung GmbH, DB InfraGO AG)
Possible facade variant of a TSO for operations control (Symbol image; Copyright: atelier4d Planung GmbH, DB InfraGO AG)

​The identical construction of the TSO described above is achieved using standardised sample planning based on the European standard DIN EN 50600 "Information technology - Data center facilities and infrastructures". This is intended to accelerate the overall rollout for the construction of the TSO. In addition, the implementation of industry-proven standards will help to raise the reliability and security of the TSO to an even higher level in the future.

​

​The first construction activities as part of the TSO are scheduled to begin in 2025. Approximately five years are scheduled for the planning and construction of a TSO. The majority of the TSO should be realised by 2031.​

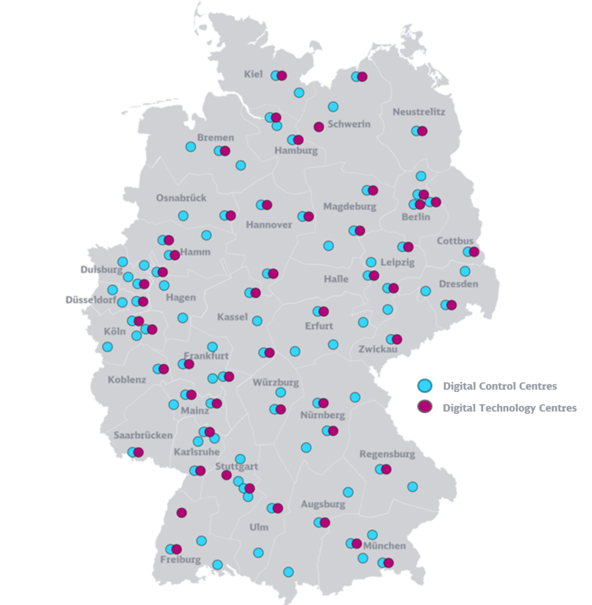

BSO and TSO of the Operational Control Strategy (Copyright: DB InfraGO AG) BSO and TSO of the Operational Control Strategy (Copyright: DB InfraGO AG)
Operational centers and technical systems centers of the Operational Control Strategy (Copyright: DB InfraGO AG)

2019

Start

Start of the Operational Control Strategy

2022

Start pilot projects

Start of pilot projects in Krefeld, Mainz and Rostock​

2024

Start of BSO construction

Start of construction activities for the 1st BSO

2025

Start of TSO construction

Start of construction activities for the 1st TSO

2031

Completion of TSO rollout

TSO implementation concept implemented across Germany

2034

Completion of BSO rollout

BSO implementation concept implemented across Germany
